The Last Big Piece: ITER’s Final Vacuum Vessel Sector Reaches Cadarache

Europe has delivered the fifth and last of its vacuum vessel sectors for the ITER fusion experiment in southern France — the ninth and final sector overall — closing a 16-year manufacturing programme and putting every core component of the machine on site.

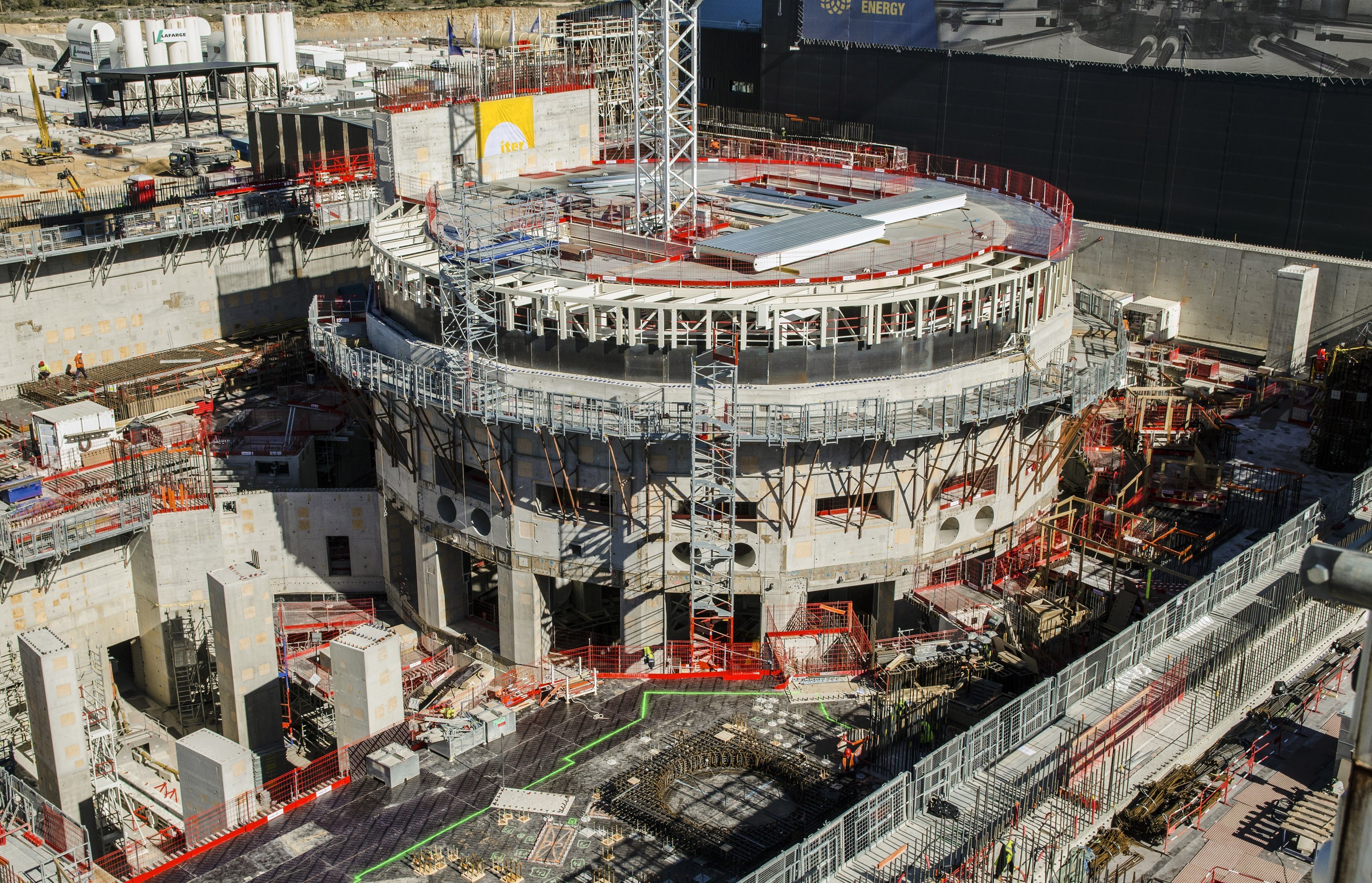

The ITER tokamak complex at Cadarache during construction
The ITER tokamak complex at Cadarache — the building into which all nine vacuum vessel sectors, the last of them delivered on 2 October 2026, have now converged.Photo: Oak Ridge National Laboratory, Wikimedia Commons (CC BY 2.0) Source

The last large component of the ITER fusion machine arrived at Cadarache, in southern France, on Friday 2 October 2026: vacuum vessel sector #2, built in Europe, delivered still in its protective wrapping. On Monday 5 October the ITER community gathered on the worksite to mark the milestone — the ninth and final sector of the vessel that will house the fusion reaction.

With this delivery, every component needed to complete the core ITER machine is now on site. The ITER Organization lists them: all toroidal field coils, poloidal field coils, correction coils, central solenoid magnets, vacuum vessel sectors and thermal shield sets have converged at Cadarache, many of them after decades of development in factories across the ITER member states.

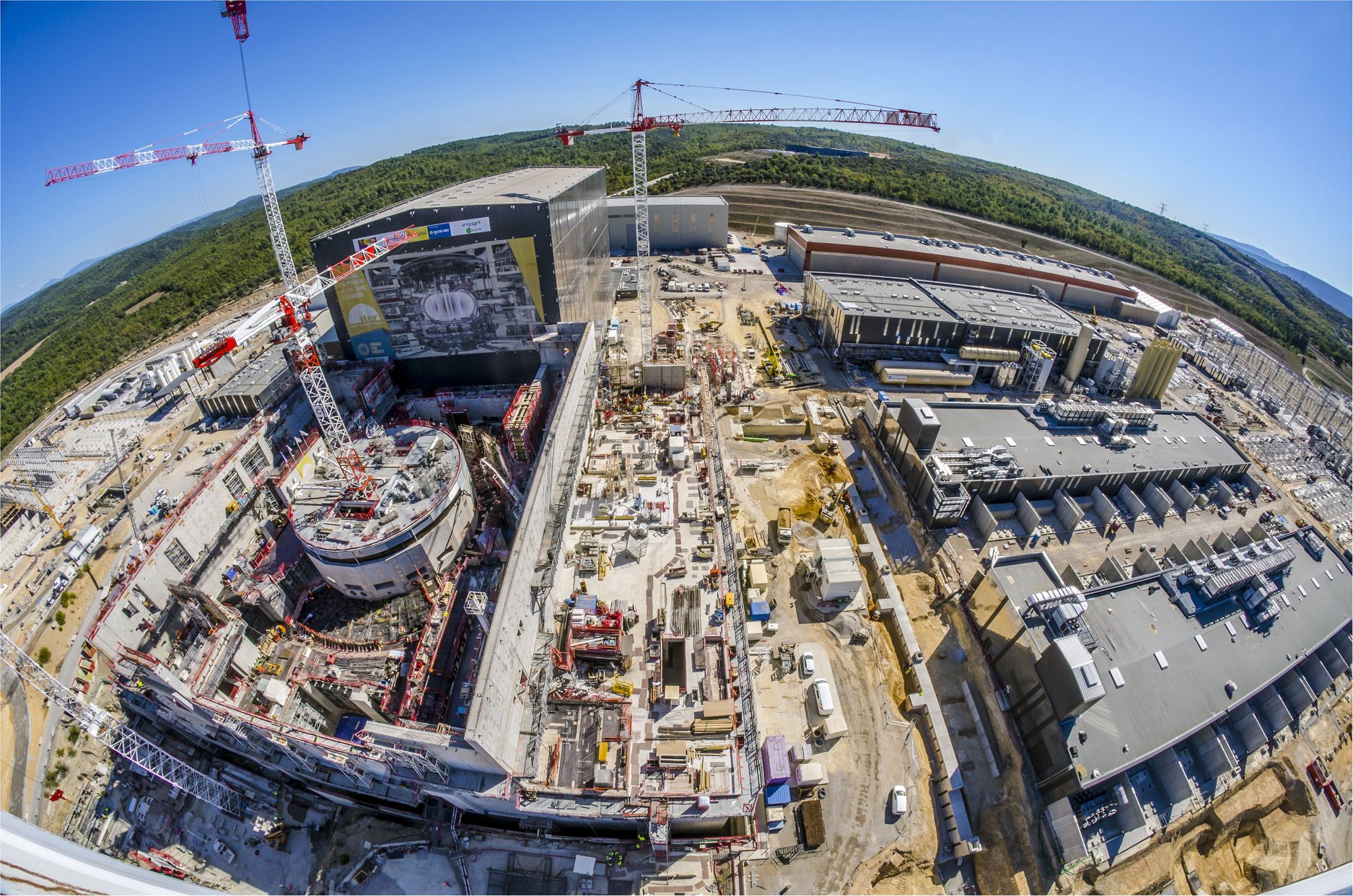

Aerial view of the ITER construction site at Cadarache, France
An aerial view of the ITER site at Cadarache in southern France, where the core machine’s components — coils, magnets, vessel sectors and thermal shields — are now all on site.Photo: Oak Ridge National Laboratory, Wikimedia Commons (CC BY 2.0) Source

“the delivery of the last vacuum vessel sector will allow us to pursue machine assembly activities according to schedule”

— Pietro Barabaschi, ITER Director-General

Sixteen years in the making

The vacuum vessel has nine sectors in total: Europe produced five and the Republic of Korea four. Europe’s five were made by Fusion for Energy (F4E), the European Domestic Agency, with the AMW consortium — Ansaldo Nucleare, Westinghouse Electric Company and Walter Tosto — across a supply chain of at least 15 companies. Sector segments were produced at Westinghouse’s Monfalcone works and Walter Tosto’s Chieti works in Italy, assembled and welded into complete sectors, then transported by sea and land to Cadarache; logistics provider DAHER moved the final sector, which left Monfalcone in mid-September. All five European sectors were delivered over the past two years, at the end of a programme Europe worked on for more than 16 years.

“It’s a high-tech component made in Europe, by European companies”

— Marc Lachaise, Director of Fusion for Energy

The vessel itself is a double-walled stainless-steel container inside which the plasma will burn, held away from the walls by superconducting magnets. Once its nine sectors are joined, it will measure 19.4 metres in diameter and 11.4 metres in height, and weigh approximately 5,200 tonnes. Ansaldo Nucleare counts 750 kilometres of welding beads across Europe’s five sectors — and, in a detail that says much about modern heavy industry, F4E used AI tools to cross-check the data collected by technical teams in the factories during the programme. The sectors underwent detailed inspections to meet standards set by France’s Nuclear Safety Authority.

Conductor for ITER’s central solenoid being wrapped in insulation during fabrication
Conductor for ITER’s central solenoid being wrapped in insulation during fabrication — one of the core magnet systems now fully delivered to Cadarache.Photo: Oak Ridge National Laboratory, Wikimedia Commons (CC BY 2.0) Source

Assembly is the next chapter

The work has already moved on. On 7 October 2026, ITER removed a radial beam from a sector module in the tokamak pit for the first time — an 80-tonne temporary support beam, extracted by a team of more than 20 people in under two hours — opening the way to welding in the pit. On ITER’s published schedule, the final sector module is to be lowered into the pit in spring 2027, with the last radial beam expected to be removed in September 2027.

A poloidal field coil under construction for ITER

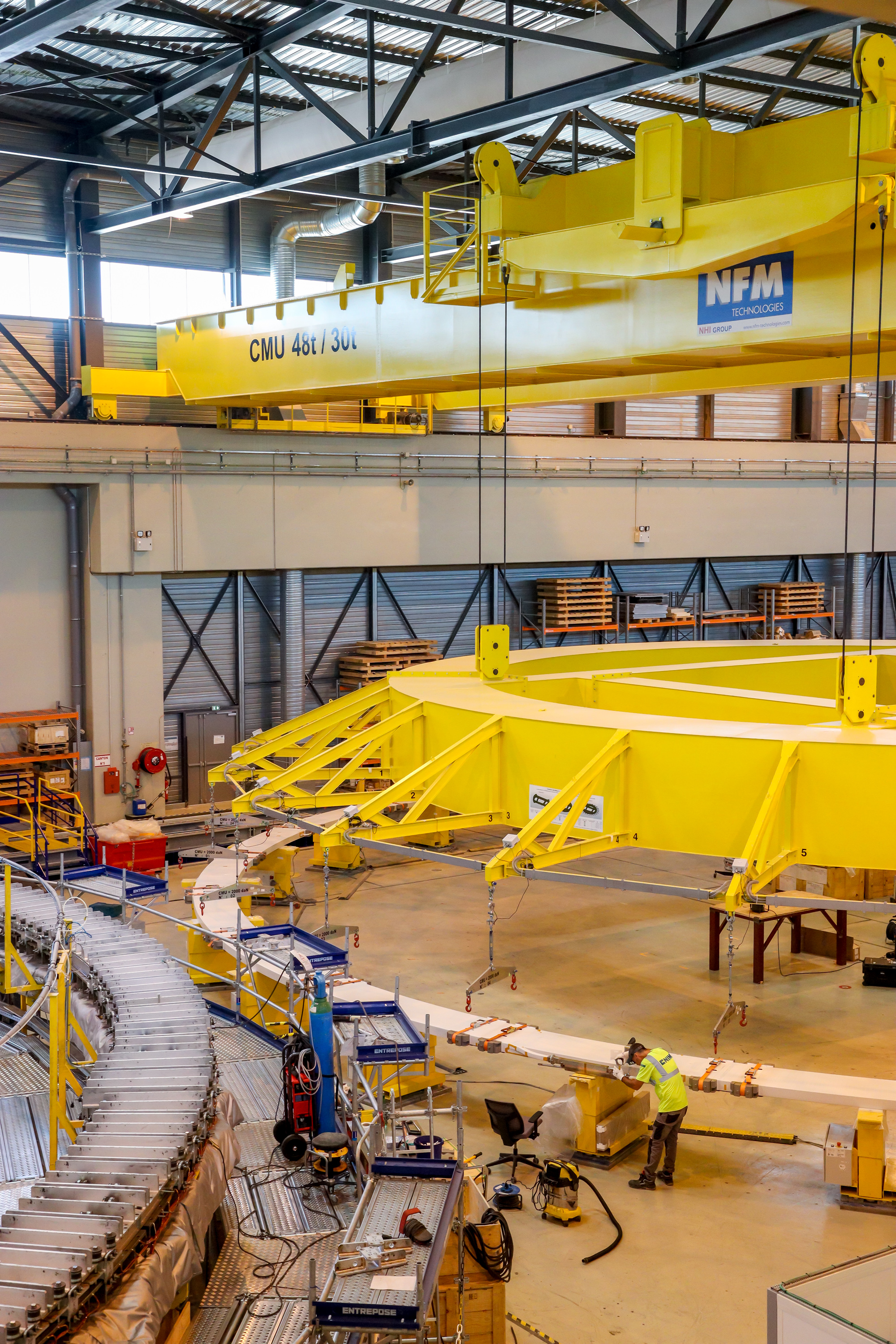

A poloidal field coil under construction for ITER. The coil sets are among the core components whose delivery the final vessel sector completes.Photo: Johannes Reimer, Wikimedia Commons (CC BY 4.0) Source

The honest caveat is ITER’s own: in-vessel components, plant systems and other equipment are still to come, and much assembly work lies ahead. But the disruption lens of this milestone is logistical, not physical. Fusion’s hardest problem for a generation has been industrial — whether components of this size and precision could be manufactured on three continents and made to meet in one pit in Provence. With the ninth sector on site, that question has its answer.
